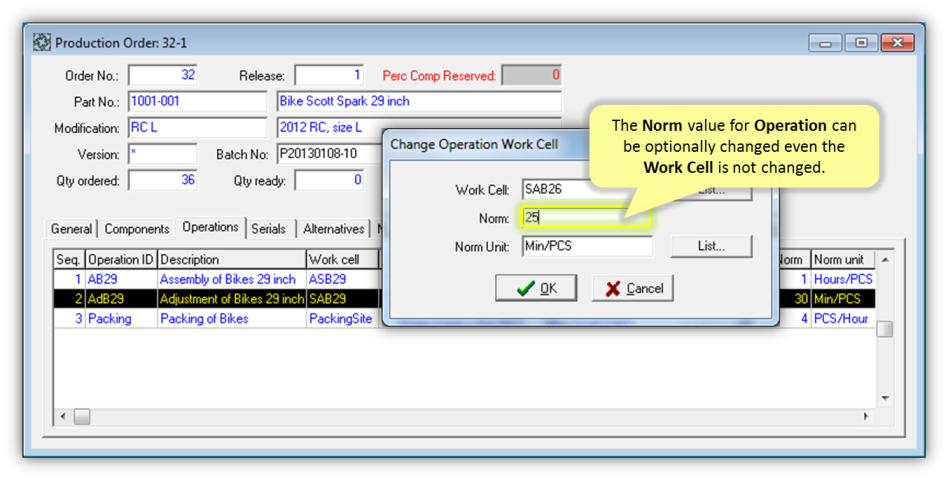

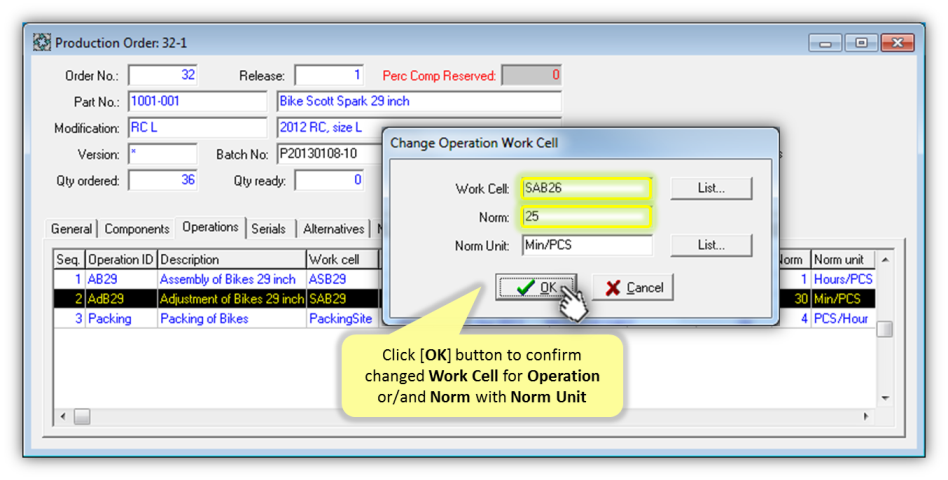

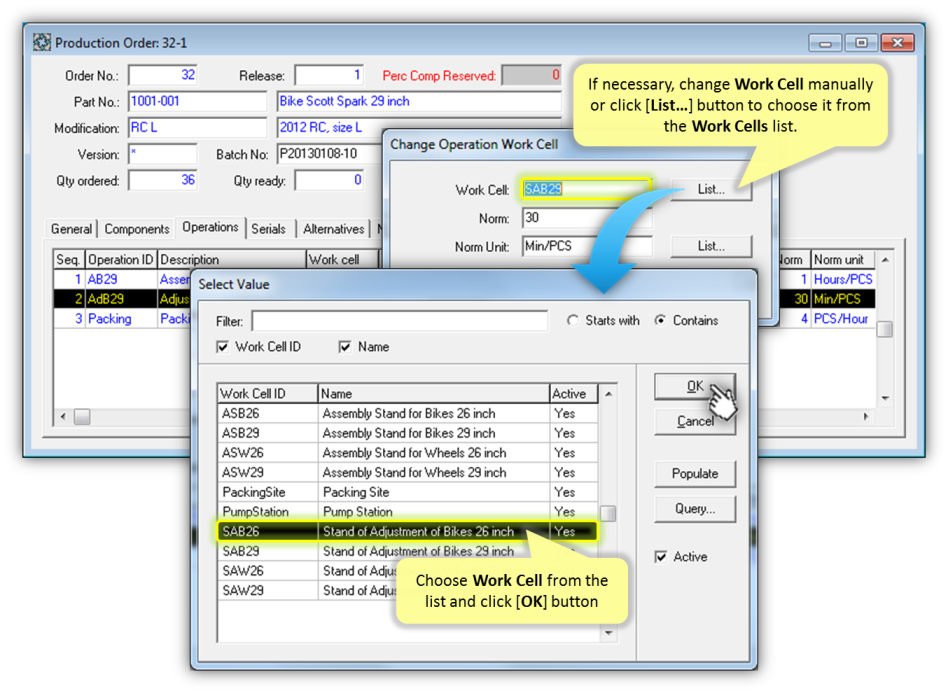

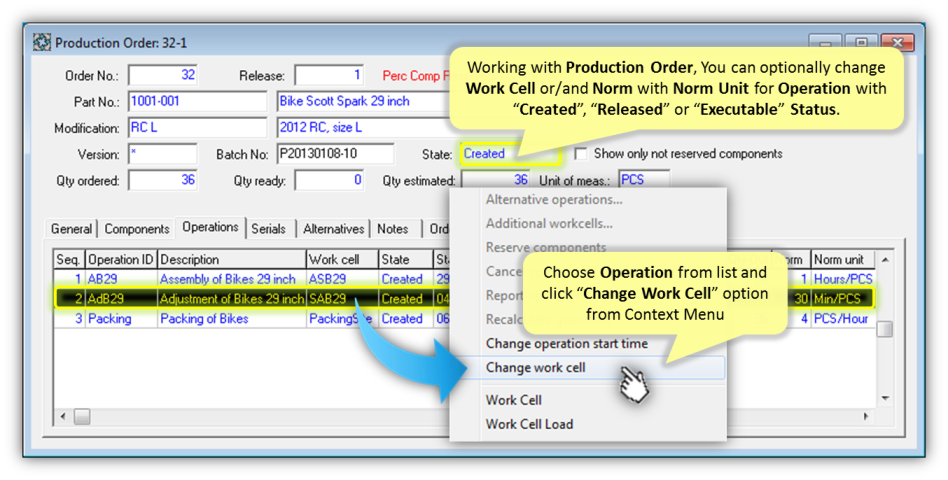

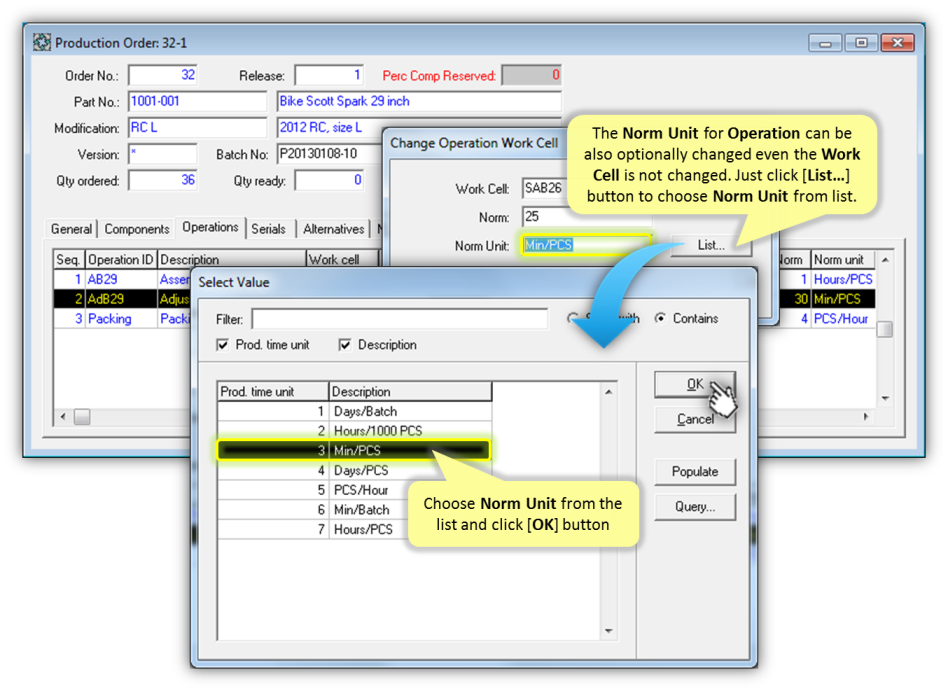

Working with Production Order, You can optionally change Work Cell or/and Norm with Norm Unit for Operation with “Created”, “Released” or “Executable” Status. It is useful, for example, when initially planned Work Cell is overloaded for the specific date range or broken, or duration of Operation should be recalculated using changed Norm with Norm Unit. If Operation is already started, then possibility to change Work Cell or/and Norm with Norm Unit will be disabled for this Operation.

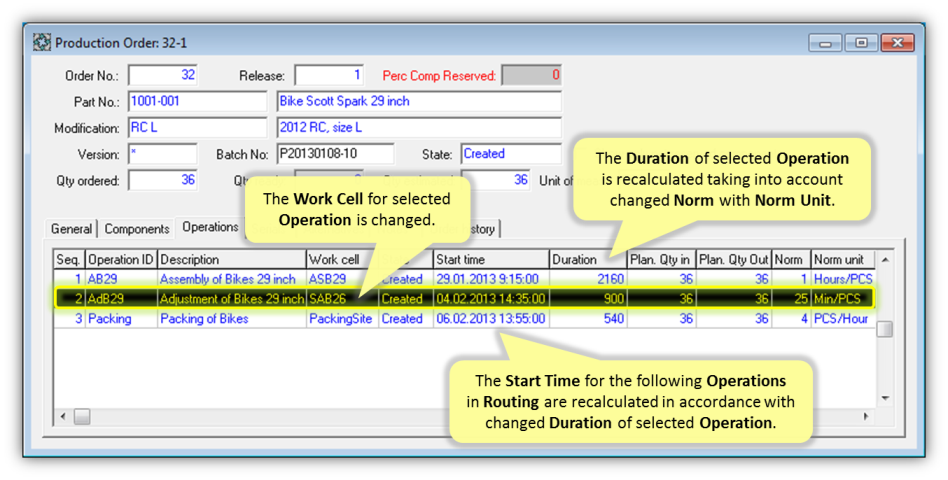

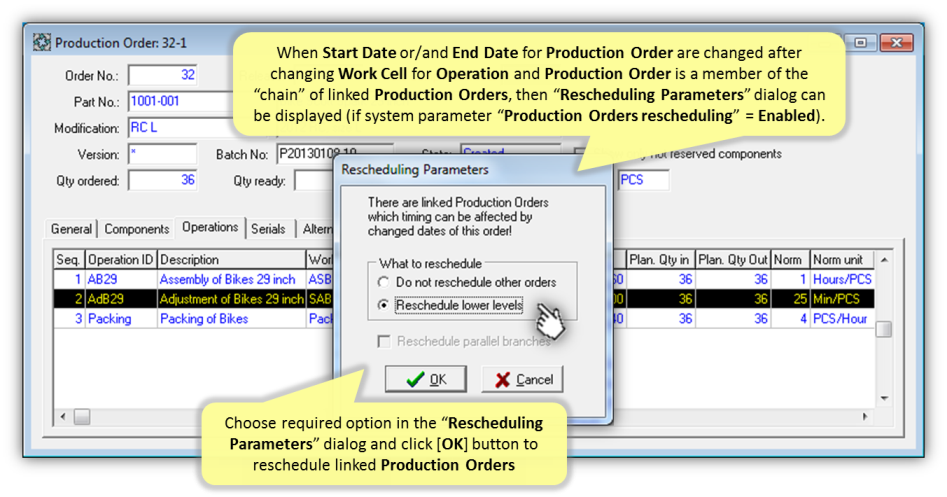

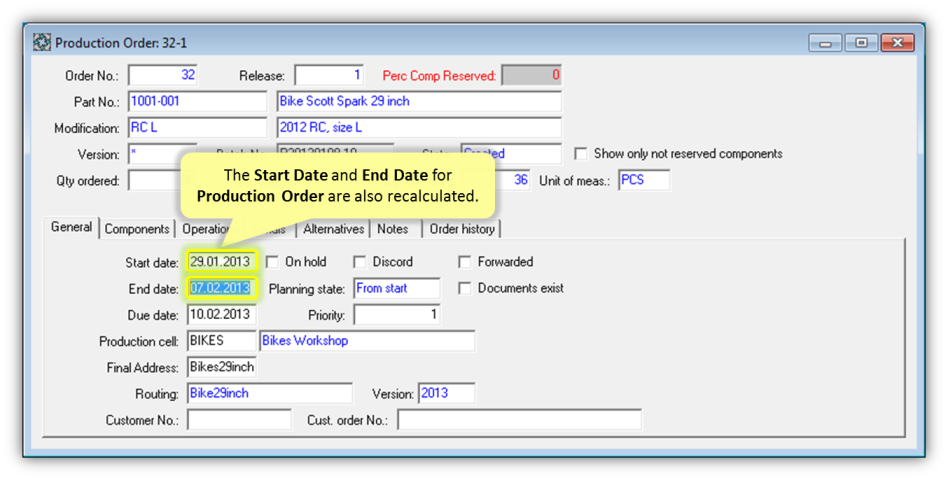

If duration of Operation is changed, then other following Operations will be rescheduled automatically. The related Start Date and End Date of Production Order will be updated appropriately. When Start Date or/and End Date for Production Order are changed after rescheduling Operations and Production Order is a member of the “chain” of linked Production Orders, then “Rescheduling Parameters” dialog can be displayed (if system parameter “Production Orders rescheduling” = Enabled).
